Basel IV: The Accelerant

Basel IV doesn't force anyone to adopt stablecoin rails. It raises the cost of correspondent banking enough that the comparative economics flip - right as stablecoin infrastructure becomes institutionally viable.

By , Co-Founder & CEO · Plexo Institute

Basel IV raises the cost of correspondent banking just as regulated stablecoin settlement becomes institutionally viable.

Basel IV doesn't force anyone to adopt stablecoin rails. It raises the cost of correspondent banking enough that the comparative economics flip - right as stablecoin infrastructure becomes institutionally viable.

Reading Guide

Four ideas to anchor how bank capital reform changes the economics of cross-border payment infrastructure.

The perspective follows the capital mechanics first, then the implementation window, then the corridor-level substitution logic. The thesis is not that Basel IV creates stablecoin adoption by itself. It is that Basel IV raises the cost of the incumbent correspondent model at the same moment regulated alternatives become easier to defend.

Basel IV's standardized credit risk floor caps the benefit G-SIBs got from internal models on correspondent exposures. The same banks face a cross-jurisdictional activity surcharge under the GSIB framework that scales with nostro book size. The two effects compound - the same correspondent relationship now costs more capital under credit risk and more capital under systemic risk. Mid-rated emerging-market correspondents are where the squeeze is sharpest.

EU CRR3 / CRD6 took effect January 2025; EU G-SIBs, including BNP Paribas, Deutsche Bank, Santander, ING, and UniCredit, are already applying the standardized floor. The UK PRA has set Basel 3.1 implementation for January 2027. The US Basel III endgame remains a calibration and final-rule watch item rather than a live phase-in. Emerging-market jurisdictions adopt unevenly through 2028-2030. The asymmetry creates transitional windows where emerging-market operators can absorb flows before local Basel IV adoption closes them.

The capital math in this analysis: a 100% RWA floor on mid-tier correspondent exposures, up from 50-70% under internal models, implies $300-500M of additional capital per $10B of book at typical CET1 ratios. Applied across a large G-SIB correspondent book, this becomes billions in capital that generates no incremental revenue. The CBR decline started before Basel IV - partially Basel-driven through capital cost and partially AML-driven through compliance cost. Basel IV adds a second layer of pressure to the same trend rather than initiating it.

The GSIB cross-jurisdictional indicator counts claims and liabilities on foreign counterparties. A stablecoin transit creates a claim that exists for minutes, not periods. It does not show up on the balance sheet at period-end in the same category as a nostro balance. This is regulatory arbitrage in the legitimate sense: the architecture corresponds to how risk actually manifests. Basel IV charges capital against prolonged foreign exposure, not against payment transit. The comparative economics flip on the marginal correspondent relationship - not by making correspondent banking obsolete, but by making stablecoin substitution defensible where it previously was not.

Chapter 1

What Basel IV Is

Basel IV is the finalization of post-2008 bank capital reform, and its payment effect comes through the cost of holding correspondent exposures.

Basel IV is the colloquial name for the final post-2008 bank capital reforms agreed by the Basel Committee in December 2017. Officially it is the Basel III finalization. The label Basel IV stuck because the cumulative changes feel like a new regime.

Core changes

TermTraditional finance equivalent

Standardized credit risk

A new standardized approach for credit risk.

Output floor

A 72.5% floor on internal-model risk-weighted assets.

Market risk

A revised market risk framework, including FRTB.

Operational risk

Tighter operational risk capital through standardized measurement.

Most Basel coverage focuses on bank capital ratios and systemic risk. The payments-specific effect is less discussed but equally structural. Correspondent banking exposures become more expensive to hold. Cross-jurisdictional activity becomes a supervisory trigger. The two effects compound: each bank has more reason to shrink its correspondent book and less reason to grow it.

This is why Basel IV is not just a bank capital story. It is a cross-border payments story.

Chapter 2

What Changes for Cross-Border Payments

Three mechanisms inside Basel IV directly raise the cost of correspondent banking.

The core payment effect is not one single rule. It is the combination of a standardized credit risk floor, systemic surcharge pressure on cross-jurisdictional claims, and updated operational risk capital. Each mechanism can be defended on safety grounds; together they make marginal correspondent relationships harder to justify.

MechanismEffect on correspondent banking

Standardized credit risk floor

Large banks using internal models for correspondent exposures must now hold at least 72.5% of the RWA a standardized-approach bank would hold. This eliminates the internal-model advantage G-SIBs relied on.

Cross-jurisdictional activity surcharge

The GSIB framework, including FR Y-15 in the US, treats cross-jurisdictional claims and liabilities as a systemic risk indicator. More nostro exposure raises the surcharge.

Operational risk update

The Standardized Measurement Approach loads capital against business volume. Correspondent banking's revenue base increases capital consumption.

Before Basel IV, a G-SIB using internal models could classify a correspondent exposure to an emerging-market bank at 50-70% RWA. The rationale: internal loss history showed actual defaults were rare. The 72.5% floor says that even if the internal model shows lower risk, the bank must hold capital as if the risk were at least 72.5% of the standardized estimate.

For well-rated counterparties the floor is binding. For low-rated emerging-market counterparties the standardized number was already higher than the internal number, so the floor does not hurt. The squeeze falls hardest on mid-rated correspondent exposures: the ones that were the economic sweet spot for G-SIBs.

The GSIB surcharge scales with cross-jurisdictional activity, size, interconnectedness, complexity, and substitutability. A bank that aggressively grows its correspondent book increases the first indicator. The surcharge calibration is a moving target: the Federal Reserve has proposed tightening calibration as part of Basel III endgame implementation.

Effect: G-SIBs are now managing correspondent exposure not just for credit risk but for systemic-risk signaling. That is a second-order capital cost layered on top of the first.

Chapter 3

Implementation Timeline

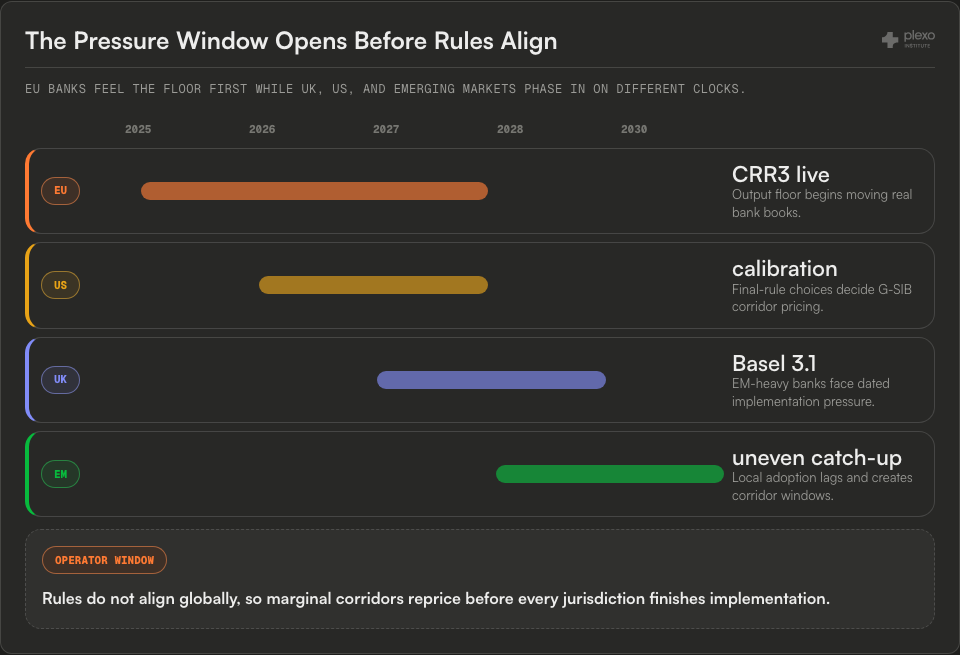

The critical window is 2025-2028, with major jurisdictions phasing the floor on different clocks.

The critical window is 2025-2028. This analysis frames this as the period when EU implementation is already live, UK implementation comes into force, US calibration is decided, and emerging-market adoption remains uneven through 2030.

The Pressure Window Opens Before Rules Align


EU banks feel the floor first while UK, US, and emerging markets phase in on different clocks.
  1. EU

    CRR3 live

    Output floor begins moving real bank books.

  2. US

    calibration

    Final-rule choices decide G-SIB corridor pricing.

  3. UK

    Basel 3.1

    EM-heavy banks face dated implementation pressure.

  4. EM

    uneven catch-up

    Local adoption lags and creates corridor windows.

operator windowRules do not align globally, so marginal corridors reprice before every jurisdiction finishes implementation.
Text representation of the source implementation timeline.
WindowSource milestone

2023-2024

Phase-in begins.

2025

2026

US Basel III endgame remains a final-rule and calibration watch item.

2027

2028

Broad alignment target in this analysis, with local adoption still uneven.

The EU's Capital Requirements Regulation 3 and Capital Requirements Directive 6 took effect January 2025. The EU implemented the output floor on schedule. EU G-SIBs, including BNP Paribas, Deutsche Bank, Santander, ING, and UniCredit, are now applying the full standardized floor to correspondent exposures.

Effect already visible in this analysis: selective de-risking of mid-tier African and Latin American correspondents.

The US Basel III endgame proposal was issued in July 2023 and revised in the 2024-2026 policy process. The calibration of the cross-jurisdictional surcharge and the output floor are the two parameters operators should track. Until final rules are adopted, the US should be treated as a pending calibration case rather than a live phase-in.

US G-SIBs, including JPMorgan, Citi, BNY Mellon, and Bank of America, are the largest correspondent banks globally. Their Basel IV implementation determines the pace at which the capital cost is reflected in correspondent banking economics.

The Bank of England and PRA set January 2027 for full Basel 3.1 application. HSBC and Standard Chartered are the most affected in this analysis: both are heavy emerging-market-facing correspondent banks. Capital ratio impact is estimated at 100-300 bps depending on the book.

Emerging-market jurisdictions are adopting Basel IV on varying timelines. Singapore, Hong Kong, UAE, and Australia are roughly aligned with 2025-2027. India, Brazil, and China are framed as 2027-2029. Most African jurisdictions are framed as 2028-2030.

This creates a transitional arbitrage window where emerging-market operators can absorb flows before local Basel IV adoption closes them.

Chapter 4

The New Math

The capital cost of holding correspondent exposure has risen measurably, even when the numbers are illustrative.

The capital cost of holding correspondent exposure has risen measurably. This analysis uses two numbers to illustrate the direction, while making the exact bank-level impact dependent on internal models, counterparty mix, and operational risk measurement.

100%
RWA floor on mid-tier correspondent exposures.

This analysis frames this as up from 50-70% under internal models.

$300-500M
Additional capital required per $10B of correspondent exposure.

Illustrative scenario estimate at typical CET1 ratios.

Applied across a large G-SIB correspondent book, this analysis frames this as billions in additional capital required to maintain the same footprint. The capital generates no incremental revenue. Return on correspondent banking assets falls. The activity becomes harder to defend internally.

In theory, a G-SIB could raise correspondent banking fees to offset the capital cost. In practice, fee increases face two constraints: emerging-market correspondents have limited ability to pay, and the Financial Action Task Force has pressured G-SIBs not to exit emerging markets purely for cost reasons.

Result: G-SIBs cannot fully reprice, so they de-risk instead. They exit the relationships that are not defensible rather than raise fees that cannot be collected. This is why Basel IV accelerates the existing CBR decline rather than merely adjusting pricing.

Basel IV does not operate in isolation. Anti-money-laundering and know-your-customer rules have raised per-relationship compliance costs independently. For a marginal correspondent relationship, the G-SIB now faces both higher capital charges and higher operating costs. The math rarely works.

This is why the source links the 2013-2022 global correspondent relationship decline to pre-existing pressure before Basel IV. Basel IV adds a second layer to the same trend.

Chapter 5

Why Accelerant, Not Trigger

Basel IV does not force adoption. It raises the cost of the status quo enough that alternatives look relatively cheaper.

Basel IV does not force anyone to adopt stablecoin rails. It raises the cost of the status quo enough that comparative economics flip. A G-SIB evaluating whether to invest in a new correspondent relationship in Africa increasingly finds the numbers do not work. The same bank evaluating a stablecoin settlement integration may find them workable, because regulated stablecoin rails do not trigger the cross-jurisdictional activity surcharge in the same way.

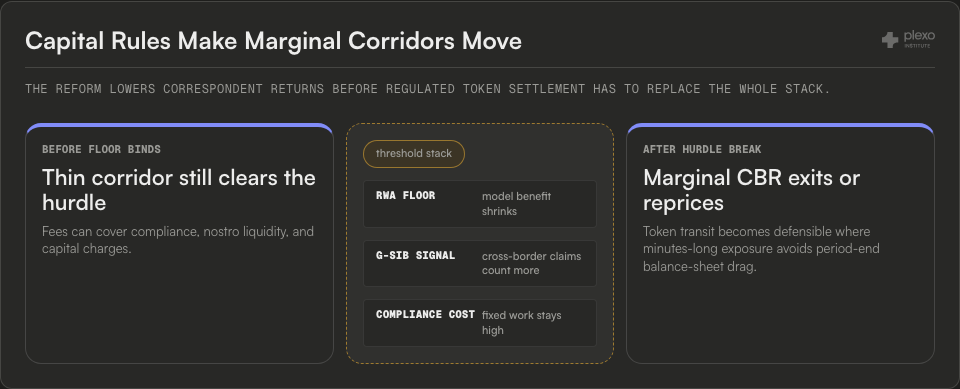

Capital Rules Make Marginal Corridors Move


The reform lowers correspondent returns before regulated token settlement has to replace the whole stack.

Before floor binds

Thin corridor still clears the hurdle

Fees can cover compliance, nostro liquidity, and capital charges.

threshold stack
RWA floormodel benefit shrinks
G-SIB signalcross-border claims count more
compliance costfixed work stays high

After hurdle break

Marginal CBR exits or reprices

Token transit becomes defensible where minutes-long exposure avoids period-end balance-sheet drag.

Text representation of the source accelerant flow.
StepEffect

Basel IV tightens capital

Correspondent banking return on equity falls.

G-SIBs shed marginal correspondent relationships

De-risking continues.

Alternatives look relatively cheaper

Stablecoin clearing and tokenized deposits become easier to defend.

The cross-jurisdictional activity indicator counts claims and liabilities on foreign counterparties. A stablecoin transit - fiat in, stablecoin transit, fiat out - does not create a long-term claim on a foreign counterparty in the same way a nostro balance does. The exposure exists for minutes. It does not show up on the balance sheet at period-end in the same category.

This is regulatory arbitrage in the legitimate sense: the architecture was designed to correspond to how risk actually manifests. Basel IV charges capital against prolonged foreign exposure, not against payment transit.

Basel IV does not make correspondent banking obsolete. Large, high-quality correspondent relationships between G-SIBs in G7 jurisdictions remain economically viable. The mid-tier and emerging-market-facing relationships are the ones under pressure.

Stablecoin rails do not replace correspondent banking entirely. They substitute for the marginal relationships that Basel IV makes uneconomic. This is why the adoption curve looks like corridor-by-corridor substitution, not wholesale replacement.

Chapter 6

Jurisdictional Asymmetry

Basel IV does not hit every jurisdiction equally, so the effect lands first where the largest correspondent books meet the earliest implementation clocks.

Basel IV does not hit every jurisdiction equally. Three asymmetries shape where the effect lands: proactive regimes absorb the first-order bank-capital effect, emerging-market banks feel the second-order access effect, and regulated stablecoin operators become positioned to absorb flow where they already have licenses.

G-SIBs in proactive regimes face Basel IV earliest and most aggressively. EU implementation is live, UK implementation is dated for January 2027, and US G-SIBs remain the critical pending calibration case. These are also the banks with the largest correspondent banking books. The de-risking trend that began in 2013-2015 accelerates. The current map indicates that the 34% decline in global CBRs between 2011 and 2022 is partially a capital-cost effect. Basel IV extends and deepens it.

Emerging-market banks holding correspondent relationships with G-SIBs get notices. Some relationships close. Fees on the remaining ones rise. Africa's correspondent banking decline, stated in this analysis as 44.2% since 2011, is partially Basel-driven. When the G-SIB shrinks its book, the emerging-market bank loses access.

The emerging-market bank's options: concentrate at fewer G7 correspondents, seek regional alternatives, or adopt stablecoin settlement. The first is expensive and concentrated; the second has limited availability; the third is new but increasingly viable.

Regulated stablecoin rails operate outside the correspondent banking capital structure. They substitute technology-mediated settlement for capital-intensive bilateral accounts. Basel IV does not make them free. It makes them comparatively cheaper.

The operators best positioned are those that have already secured regulated licenses in proactive or permissive jurisdictions. They can offer G-SIBs a settlement alternative that is compliant with the same supervisory frameworks, without the capital drag.

Chapter 7

What Operators Should Track

Three signals indicate how fast Basel IV is reshaping correspondent banking in a given jurisdiction.

This analysis identifies three specific signals operators should track. The point is not to predict Basel implementation abstractly; it is to watch when capital pressure shows up in correspondent books, surcharge calibration, and local adoption windows.

EU CRR3 full phase-in from 2025 to 2028. Watch G-SIB correspondent book disclosures in 2026-2027 annual reports.

US Basel III endgame final rule. The cross-jurisdictional surcharge calibration is the specific parameter to watch.

Emerging-market jurisdictional implementation. Uneven Basel III / IV adoption creates windows where emerging-market operators can absorb flows before local Basel IV adoption closes them.

Top-10 G-SIBs disclose counterparty concentration in Pillar 3 reports. The number of correspondent relationships, total cross-border claims, and geographic distribution are all reported. Tracking year-over-year changes in these disclosures provides the earliest visible signal of Basel IV's effect on the correspondent network.

Counter-Arguments & Limitations

Where the accelerant thesis can be challenged.

Two objections define the boundary of the thesis: G-SIBs may reprice rather than de-risk, and supervisors may reclassify stablecoin transit exposure. Both objections matter because the accelerant thesis depends on relative economics and on supervisory interpretation.

The repricing case: if Basel IV adds $300-500M of capital per $10B of exposure, a G-SIB could in principle raise correspondent fees by 15-30 bps and recover the cost. Some repricing is happening in this analysis: observed correspondent spreads on USD clearing have widened in 2024-2025.

Limits to repricing: emerging-market correspondents have limited ability to pay higher fees without losing competitiveness in their own retail markets. FATF has explicitly pressured G-SIBs not to exit emerging markets purely on cost grounds, which constrains how aggressively fees can be raised on the most stressed relationships. The result is partial repricing on tier-1 correspondents and de-risking on tier-2 and tier-3 - exactly the bifurcation visible in the 2013-2022 CBR data. Basel IV intensifies the bifurcation rather than reversing it.

The transit-exposure interpretation depends on how supervisors apply the GSIB cross-jurisdictional indicator to stablecoin flows. A conservative supervisory stance could reclassify aggregate stablecoin throughput as a cross-jurisdictional liability of the issuing or settling bank, which would partially close the arbitrage.

The counter-counter: the architectural difference is real - minutes-long transit versus period-end nostro claim - and supervisors generally follow economic substance. EU MiCA, US GENIUS Act, and UK FSMA frameworks have not signaled aggressive reclassification of regulated stablecoin transit in this analysis. The arbitrage is not unconditional, but as of 2026 the argument is that it persists and that regulatory direction in proactive jurisdictions confirms the carve-out rather than closing it.
